|
||
|
||
This page last updated December 21, 2024 |
This page contains information about current and future major freeway expansion and improvement projects in the San Antonio area. Minor projects, as well as maintenance and repair jobs, are not included (there's just not enough room to list them all here!) Data for this page comes primarily from official TxDOT, ARMA, and MPO project databases, as well as from media reports and the author's personal knowledge. All information is subject to change.
This is not an official website. The completion percentage data on this page was last updated December 21, 2024.
Got a general question about road construction? See the construction FAQ page. |
ADVERTISEMENT |
Current and near-term projects
The following is a compendium of major San Antonio area freeway projects currently underway or in advanced planning. The numbers and letters on the map correspond to the listings on the table below. Letting, start, and completion dates represent the latest estimates that could determined as of the date this page was updated.
Occasionally, TxDOT may grant extra time to complete a project due to issues beyond the contractor's control. When this happens, you may notice the completion percentage on a project decrease from one month to the next.
Because I use my own method for calculating the completion percentage, it may not always match information from other sources. In the end, construction progress is always fluid and somewhat subjective, so any advertised completion percentage should always be considered approximate.
- The contractor's estimated date if available.
- TxDOT's estimated date if available.
- My own calculation based on the number of contracted working days for the project.
I use quadrimesters starting in January for the descriptors of "early", "mid", and "late".
In the "advanced planning" section, projected start dates are either when a project is estimated to start construction if already funded, or when funding may be available for a project based on current projections. For this, I generally use the projected bid date in TxDOT's project tracker database and add a few months to that unless there are other authoritative reports of a different start date.
Project schedules are always in a constant state of flux. For projects underway, weather, resource availability, engineering issues, and other factors can cause projected completion dates to slip, and occasionally the stars align and work is completed earlier than expected. For projects in planning, funding availability, engineering issues, environmental clearances, right-of-way acquisition, utility relocation, changing priorities, and other red tape can cause projected start dates to slip. Occasionally, start dates can get moved up due to unexpected funding availability or a shift in priorities.
The upshot: All dates shown here are always subject to change.

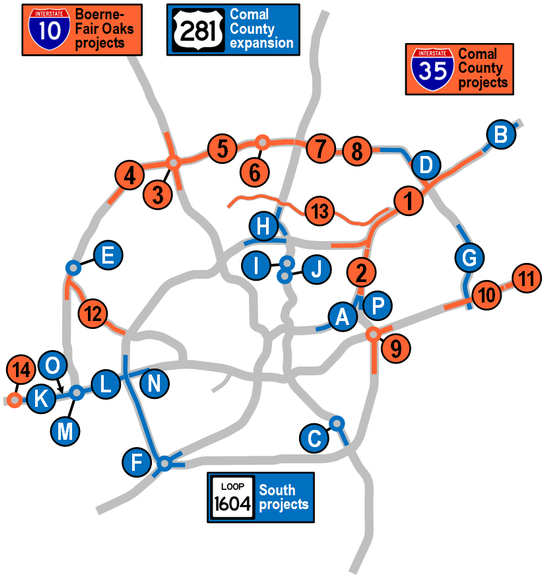

Click a number or letter on the map to see details for that project
UNDER CONSTRUCTION | ||||||
MAP ID | FREEWAY | LOCATION | PROJECT DESCRIPTION | % COMP | ESTIMATED COMPLETION |
|
|
LOOP 410 NORTH to FM 3009 | Add two elevated express lanes in each direction plus HOV lanes (Details) |
49% | Late 2027 | ||
|
LOOP 410 NORTH to LOOP 410 SOUTH | Add two elevated express lanes in each direction plus HOV lanes (Details) |
26% | Mid 2028 | ||
|
I‑10/LOOP 1604 INTERCHANGE (Northwest Side) |
Replace cloverleaf interchange with five-level direct-connect flyover interchange (Details) |
54% | Late 2027 |
||
|
BANDERA to I‑10 | Expand to 10 lane freeway including two HOV lanes (Details) |
91% | Early 2025 | ||
|
I‑10 to US 281 | Expand to 10 lane freeway including two HOV lanes (Details) |
77% | Late 2025 | ||
|
At BLANCO | Convert access road intersections to a Diverging Diamond Interchange (DDI) (Details) |
77% | Late 2025 | ||
|
US 281 to REDLAND | Expand to 10 lane freeway including two HOV lanes (Details) |
25% | Late 2027 | ||
|
REDLAND to JUDSON | Expand to 10 lane freeway including two HOV lanes (Details) |
1% | 2028 | ||
|
I‑10/LOOP 410 INTERCHANGE (East Side) |
Replace existing cloverleaf with fully-directional interchange (Phase 1); improve entrance/exit ramps and frontage roads (Details) |
87% | Mid 2025 | ||
|
LOOP 1604 to PFEIL | Expand freeway to six lanes, reconfigure Graytown Rd. intersection, and convert access roads to one-way (Details) |
99% | Early 2025 | ||
|
GRAYTOWN to GUADALUPE COUNTY LINE | Expand freeway to six lanes | 77% | Mid 2025 | ||
|
LOOP 410 to LOOP 1604 | Expand freeway to six lanes, build a new connector from westbound SH 151 to northbound Loop 1604, add turnarounds at three intersections, and various other intersection improvements (Details) |
53% | Early 2027 | ||
|
NW MILITARY to O'CONNOR | Safety improvements and TransGuide installation | 98% | Late 2024 | ||
|
AT SH 211 | Construct WB to EB turnaround | 45% | Mid 2026 | ||
ADVANCED PLANNING / SCHEDULED FOR CONSTRUCTION | ||||||
MAP ID | FREEWAY | LOCATION | PROJECT DESCRIPTION | PROJECTED START |
||
|
LOOP 410 SOUTH to WALTERS | Add two elevated express lanes in each direction (Details) |
Mid 2025 | |||
|
FM 3009 to FM 1103 | Expand to 10 lane freeway including two HOV lanes (Details) |
2027 | |||
|
SE MILITARY to LOOP 410 | Convert intersection to a Diverging Diamond Interchange (DDI) and construct southbound exit to future City Base Landing extension | 2026 | |||
|
JUDSON to I‑35 | Add two additional mainlanes in each direction plus HOV lanes (Details) |
Late 2025 | |||
|
At CULEBRA | Convert access road intersections to a Diverging Diamond Interchange (DDI) | TBD | |||
|
US 90 to SOMERSET | Expand freeway to eight lanes and construct new interchange at I-35 South | 2032 | |||
|
FM 78 to I‑10 EAST | Upgrade to four lane freeway (Details) |
2032 | |||
|
LOOP 410/US 281/ |
Package of multiple intersection improvements, ramp revisions, and auxiliary lanes to address existing chokepoints and safety issues (Details) |
2026 | |||
|
At JONES-MALTSBERGER (Quarry) | Convert access road intersections to a Diverging Diamond Interchange (DDI) (Details) |
2032 | |||
|
At BASSE | Convert existing interchange to a diamond interchange with partial Displaced Left Turn (DLT) (Details) |
2032 | |||
|
LOOP 1604 to SH 211 | Upgrade to a six lane freeway (Details) |
2028 | |||
|
LOOP 410 to LOOP 1604 | Upgrade to a eight lane freeway (Details) |
Late 2025 | |||
|
LOOP 410 to OLD HWY 90 | Operational improvements (Details) |
2032 | |||
|
US 90/LOOP 1604 |
Build remaining flyovers (Details) |
2034 | |||
|
LOOP 1604 to MONTGOMERY RD | Add westbound auxiliary lane | Mid 2025 | |||
|
AT FM 78 | Replace and widen Loop 410 overpasses and build southbound access road overpass (Details) |
Late 2024 |
